Core Idea
Satisfactory factory planning starts at the end item: the recipe panel spells out the exact inputs and rates every upstream line has to hit.
Most factories that collapse into "spaghetti" don't fail because of poor building skills, they fail because of missing planning before the first foundation goes down. This guide follows the topics covered in TotalXclipse's long-form "Factory Master-Planning" guided playthrough, focused on the habits and tools that keep a growing base organized from the early game all the way to the late tiers.
Checklist:
- Decide on a rough production target before placing any buildings
- Scout the surrounding area for resources before committing to a location
- Treat the first layout as a draft that will need revision
1. Planning Tools and Preparation

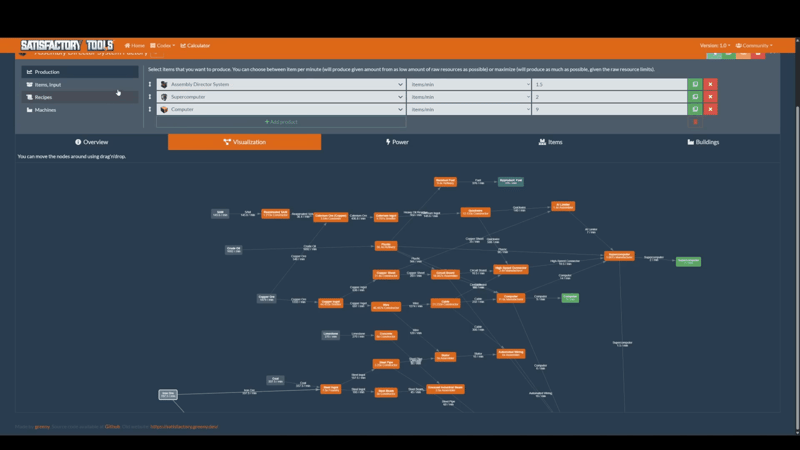

The calculator resolves the whole chain in one view, so you know every machine and belt before placing a single foundation.

Capping the planner to real map limits keeps a design honest about how much ore the world can actually supply.
Before building, sketch a rough plan using in-game tools like the Blueprint Designer preview or the map/satellite view, to estimate how much floor space a target production line will actually need.
A machine count this large is the clearest early warning of how much space, power and build time the factory will really need.
Checklist:
- Check the map view to understand resource node locations before building
- Estimate machine counts using known input/output ratios before placing foundations
- Sketch a rough zone layout before committing to permanent structures
2. Factory Location and Resource Availability

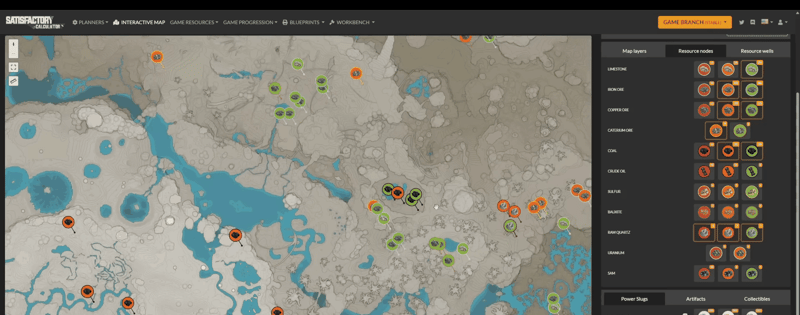

Node purity and clustering decide where a factory can stand, and the interactive map shows both at a glance.
Picking a location close to the resources a production line needs cuts down dramatically on belt and truck logistics later. Weigh the trade-off between building right on top of a resource node versus building nearby and importing ore by belt or train.
Checklist:
- Prioritize locations near multiple resource nodes of the types you need
- Check for flat, buildable terrain before settling on a site
- Leave room nearby for a train station or truck stop if the site will need imports
3. Area Logistics

Grouping every input into one ordered bus is what stops belts crossing each other later.
Once a location is chosen, laying out where belts, trains, and trucks will enter and exit the area prevents having to tear down finished production lines just to route a new import path through them later.
Checklist:
- Reserve dedicated lanes or floors for incoming and outgoing logistics
- Separate raw resource belts from finished-product belts where possible
- Plan for at least one additional import/export path for future expansion
4. Design vs Function

When the shell is drawn first, production gets chopped up to fit it — the reason function should lead and decoration follow.
There's a real distinction between building for looks and building for throughput. Get a factory hitting its production targets reliably before detailing it cosmetically, since aesthetic elements are far easier to add once the belts already work.
Checklist:
- Get production ratios correct before adding decorative elements
- Confirm belts and machines aren't bottlenecked before finalizing a build's appearance
- Save large cosmetic passes for after a section is fully functional
5. Scalability

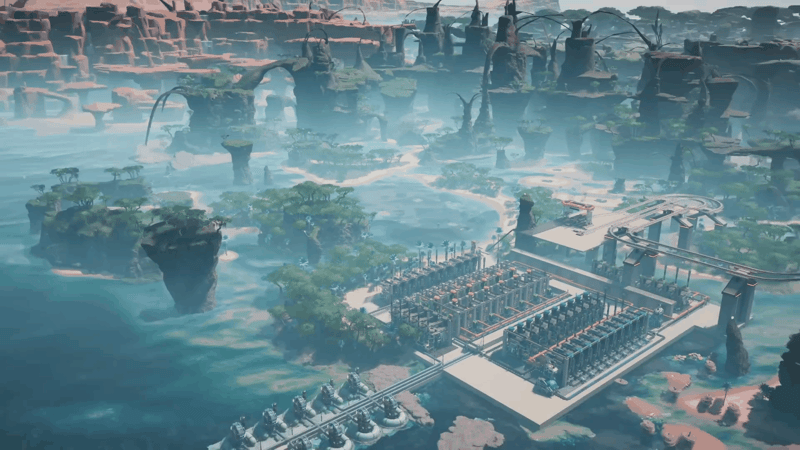

Empty space reserved around the pad is what makes the next expansion possible without demolishing anything.
Designing with future upgrades in mind, such as leaving extra foundation space or unused belt lanes, means a production line can be expanded later without a full rebuild when demand increases.
Checklist:
- Leave spare foundation space next to key production lines
- Oversize belts or add extra lanes where cheap to do so early
- Design floors with enough vertical clearance to add machines later
6. Factory Blocking

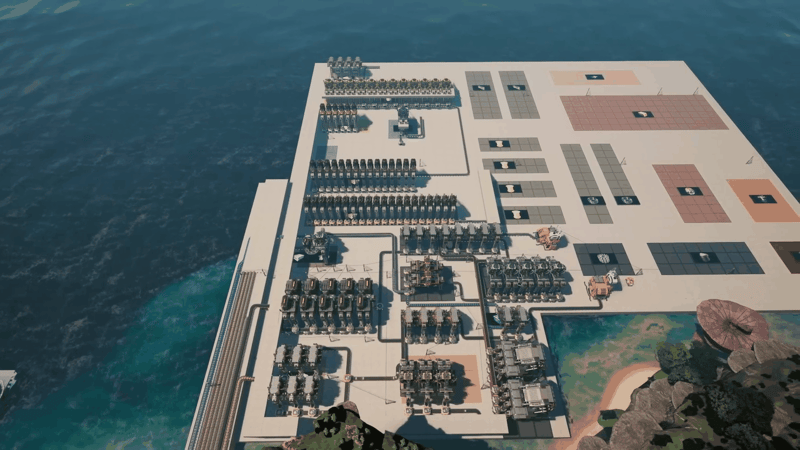

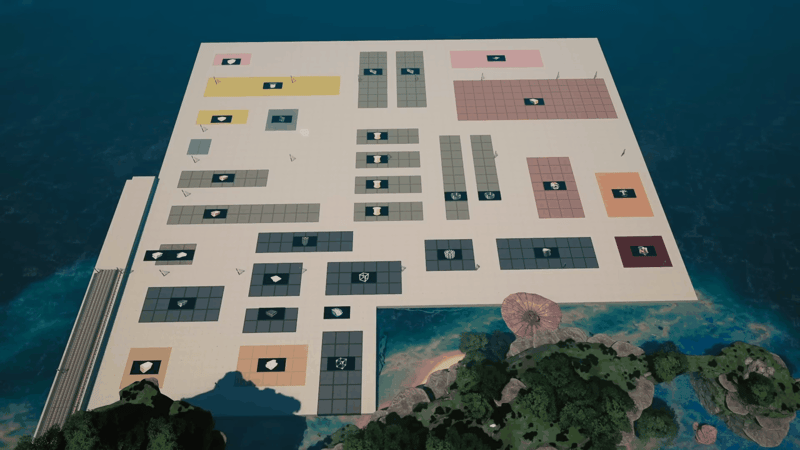

Blocking the entire layout in colour first turns a mega build into a set of small, well-spaced jobs.
"Blocking" means dividing the build site into a grid of standardized plots, similar to city blocks, so similar production lines can be repeated in a predictable footprint across the base.
Because each block was sized in advance, finished sections drop straight into place without disturbing the ones around them.
Checklist:
- Choose a standard foundation grid size for production blocks
- Keep block dimensions consistent across the factory for easy repetition
- Label or organize blocks by resource type or production tier
7. Avoiding Spaghetti

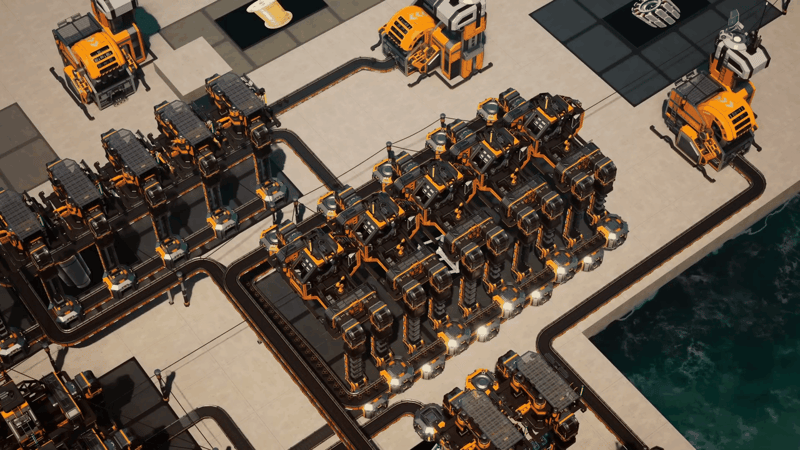

This is what the belt layer looks like before it is buried, and why routing it on its own level is worth the effort.
Spaghetti belts happen when logistics are solved reactively instead of planned. The main fix is routing belts on dedicated levels or floors rather than crossing them at random heights around machines.

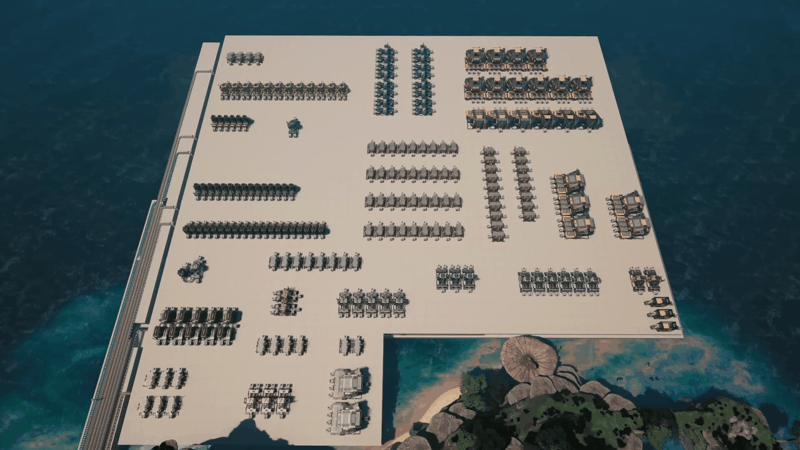

Same throughput, no visible spaghetti — the belts simply moved to the level below.
Checklist:
- Route long-distance belts on their own elevated level
- Use vertical belt lifts instead of weaving belts around obstacles
- Group parallel belts together instead of crossing them
8. Failsafes

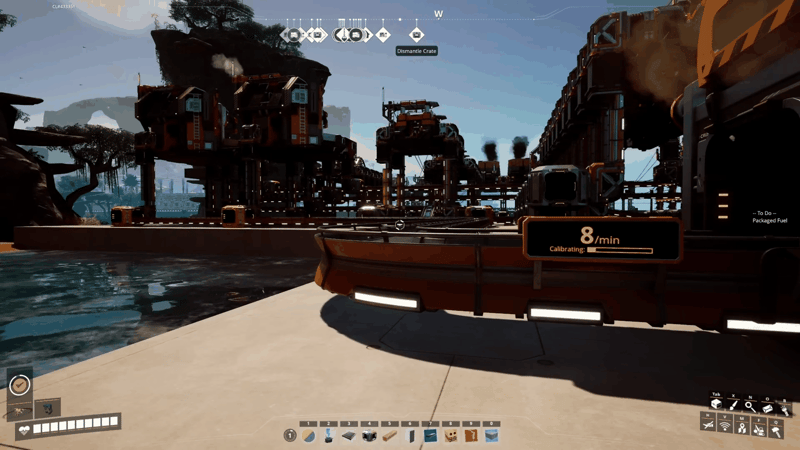

Measuring a belt against its target rate catches a wrong recipe or a starved line before the section gets built over.
Buffers such as storage containers between production stages absorb short interruptions, like a brief resource shortage or a full downstream machine, without stalling the entire line.
Checklist:
- Add storage containers as buffers between major production stages
- Include overflow handling for byproducts that aren't fully consumed
- Test what happens to the line if one machine is temporarily removed
9. Efficient Blueprints

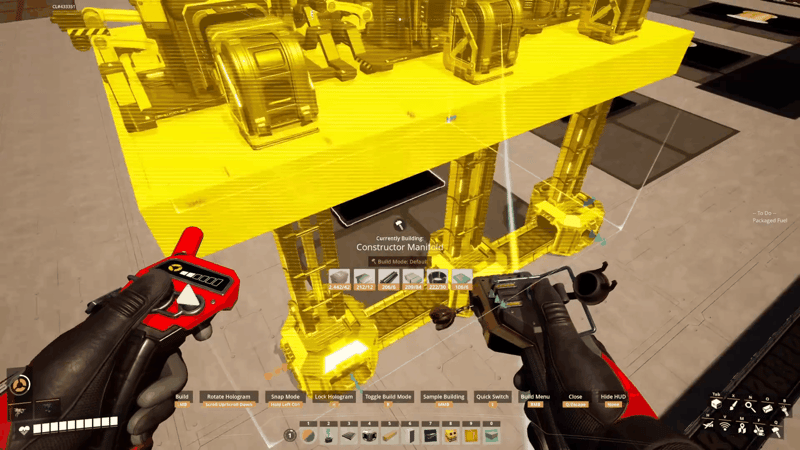

One reusable manifold blueprint covers every recipe, instead of designing a separate blueprint per section.
Saving a well-tuned production module as a Blueprint lets it be copy-pasted across the factory instantly. Design blueprints around clean input/output snap points so they connect predictably wherever they're placed.
Checklist:
- Design blueprint modules with consistent input and output points
- Test a blueprint in isolation before mass-deploying it
- Keep a personal blueprint library organized by production tier
10. Power Planning

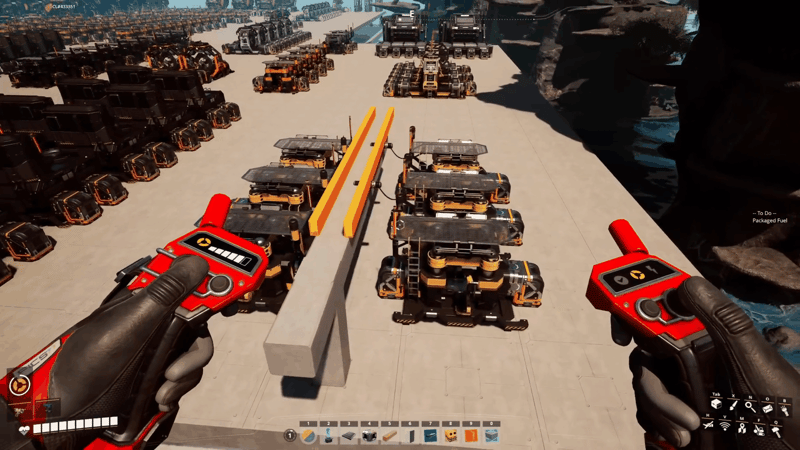

Planning power on the grid, in the gaps left by blocking, avoids wires slung diagonally across the factory later.
Treat power as part of the layout itself, reserving space for substations and power lines alongside production blocks instead of routing cables as an afterthought once machines are already placed.

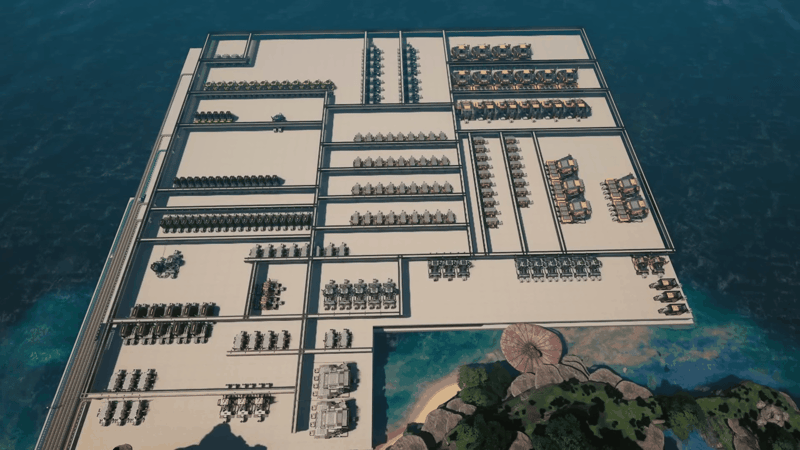

The completed base still reads as the blocked plan it started from, which is what makes it expandable.
Checklist:
- Reserve space for power infrastructure within each factory block
- Run main power lines alongside logistics corridors for easy access
- Add Power Switches between blocks to isolate outages during expansion
Sources
This guide is inspired by the YouTube video "Factory Master-Planning — A Satisfactory Guided Playthrough" by TotalXclipse.
Frequently asked
What is the best factory planner for Satisfactory?
Satisfactory Tools is the creator's pick. You set a target per minute, disable inputs like SAM, feed in what you already produce, and it returns the full production tree with machine counts, plus a maximise option that shows the ceiling from the resources you have. Alternatives are Daniel's Satisfactory Tools, the production planner and interactive map on Satisfactory Calculator, and Satisfactory Modeler on Steam. Pick whichever cuts the most work for you.
How much do alternate recipes actually reduce factory size?

On this assembly director build, the vanilla plan needed 70 constructors, 48 assemblers, 22 manufacturers, 14 refineries and 70 smelters, or 337 buildables. Swapping in coated iron plate, caterium circuit board, fused quickwire, plastic AI limiter, silicon high-speed connector, steel screws and steel frames cut that by over 100 machines and dropped iron demand from 787.5 to roughly 450 a minute, which also fits under a Mk5 belt's 780 limit.
How much space should I leave between machine blocks and how tall should a logistics floor be?
Leave a minimum of one foundation between blocks, two wherever you can, so you are never fighting to thread conveyors between rows. A logistics floor underneath wants at least 8 m of clearance, ideally 10, or it feels cramped and there is no room for lighting. Plan for more room than the calculator implies as well; this build had to expand mid-way and ended up extending out over water.
Should I overclock a machine instead of building another row?
If a line almost fits and the next row would be a squeeze, overclocking one machine per line by an extra 100 percent is a reasonable trade. It reduces the number of buildables you have to place, which matters most on huge factories, at the cost of exponentially higher power draw. This build leans on it heavily, running eight steel pipe constructors at a combined 775 percent clock speed, for instance.
How do I stop my factory turning into spaghetti?
Block it out first. Paint the foundations for each section, smelters, constructors, assemblers, before placing a single machine, so the left-to-right flow and the logistics lanes are visible up front. Order your train platforms to match the order resources enter the bus, so belt lines never have to duck under each other. Build function first and decorate after; designing the shell first is how you end up unable to fit a row of refineries.
